DataWorks provides the codeless user interface (UI) for you to develop a synchronization task without requiring you to write code. You need to only select the data sources that you want to use for data synchronization and configure the required scheduling parameters to periodically synchronize full or incremental data from a single source table or tables in sharded source databases to a single destination table. This topic describes how to configure a batch synchronization task by using the codeless UI. The configurations that are required vary based on the data source type. For more information, see Supported data source types, Reader plug-ins, and Writer plug-ins.
Background information
The batch synchronization feature of Data Integration provides readers and writers for you to read data from and write data to data sources. You can configure batch synchronization tasks for different types of data sources by using the codeless UI or code editor to synchronize data from a single source table or tables in sharded source databases to a single destination table. For more information, see Overview of the batch synchronization feature.
Usage notes
You cannot configure batch synchronization tasks for specific types of data sources by using the codeless UI. If the system displays a message indicating that the current data source does not support the codeless UI when you configure a batch synchronization task, you can click the icon in the top toolbar of the configuration tab of the task in DataStudio to switch to the code editor and configure the task by using the code editor. For more information, see Configure a batch synchronization task by using the code editor.
The codeless UI is easy to use but provides only limited features. If you want to make finer-grained configurations for your batch synchronization task, you can click the Conversion script icon in the top toolbar of the configuration tab of the task in DataStudio to switch to the code editor and configure the task by using the code editor.
Prerequisites
The data sources that you want to use are prepared. Before you configure a data synchronization task, you must configure the data source from which you want to read data and the data source to which you want to write data. This way, when you configure a batch synchronization task, you can select the data sources. For information about the data source types that are supported by batch synchronization, see Supported data source types, Readers, and Writers.
NoteFor information about the items that you need to understand before you add a data source, see Overview.
An exclusive resource group for Data Integration that meets your business requirements is purchased. For more information, see Create and use an exclusive resource group for Data Integration.
Network connections are established between the exclusive resource group for Data Integration and the data sources. For more information, see Network connectivity solutions.
Go to the DataStudio page
Go to the DataStudio page.
Log on to the DataWorks console. In the top navigation bar, select the desired region. In the left-side navigation pane, choose . On the page that appears, select the desired workspace from the drop-down list and click Go to Data Development.
Procedure
Step 1: Create a batch synchronization task
Create a workflow. For more information, see Create a workflow.
Create a batch synchronization task.
You can use one of the following methods to create a batch synchronization task:
Method 1: Log on to the DataWorks console. In the left-side navigation pane, click Workspace. On the Workspaces page, find the workspace in which you want to create a batch synchronization task and choose Shortcuts > Data Development in the Actions column. In the Scheduled Workflow pane of the DataStudio page, find the created workflow and click its name. Right-click Data Integration and choose
.Method 2: Log on to the DataWorks console. In the left-side navigation pane, click Workspace. On the Workspaces page, find the workspace in which you want to create a batch synchronization task and choose Shortcuts > Data Development in the Actions column. In the Scheduled Workflow pane of the DataStudio page, find the created workflow and double-click its name. In the Data Integration section of the workflow editing tab that appears, drag Offline synchronization to the canvas on the right.
In the Create Node dialog box, configure the parameters to create a batch synchronization task.

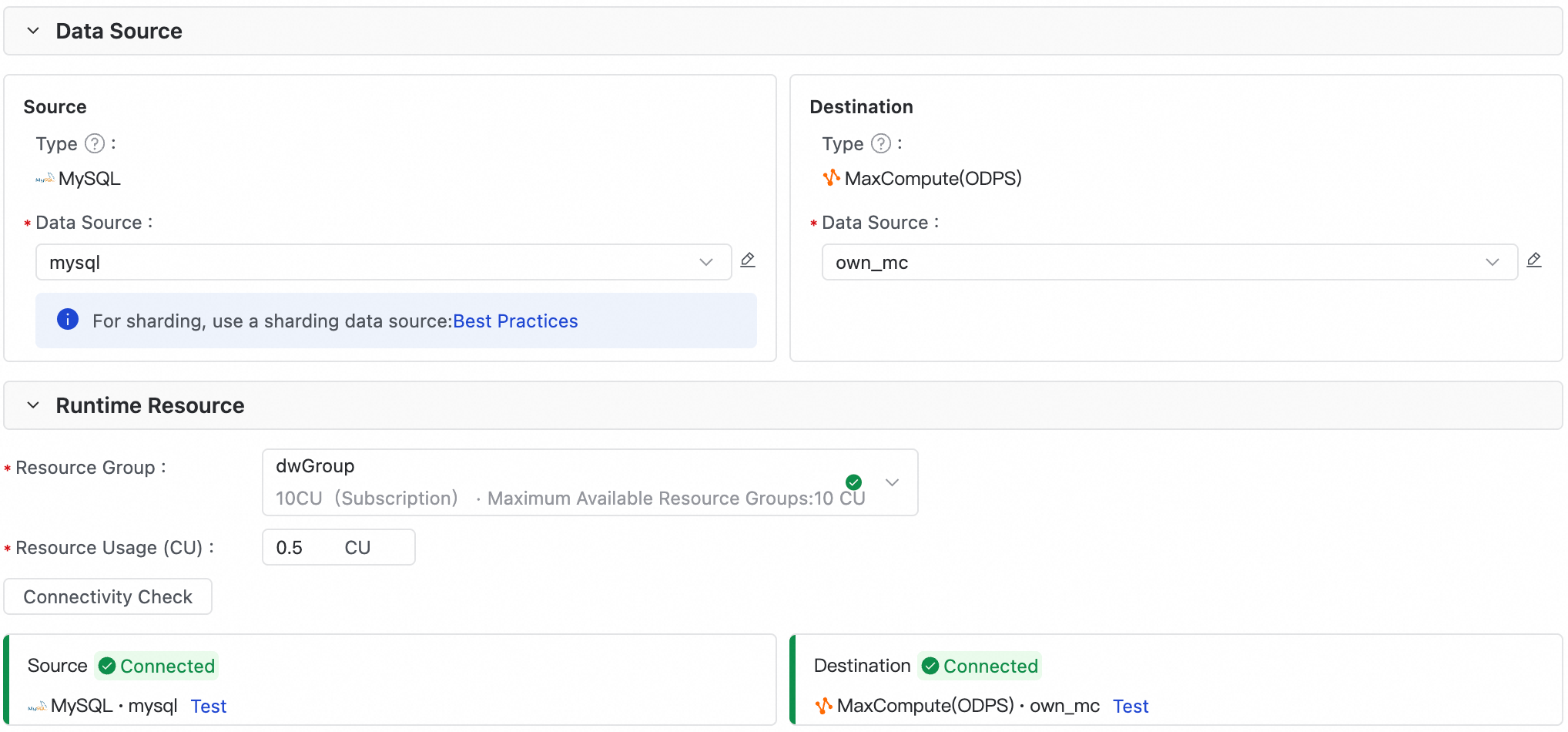

Step 2: Establish network connections between the exclusive resource group for Data Integration and the data sources
Select the source, destination, and exclusive resource group for Data Integration, and establish network connections between the resource group and data sources.
You can use a batch synchronization task to synchronize data from tables in sharded databases to a single table. For more information, see Scenario: Configure a batch synchronization task to synchronize data from tables in sharded databases.
If network connections between the exclusive resource group for Data Integration and the data sources cannot be established, you can configure the network connectivity as prompted or by referring to the related topic. For more information, see Network connectivity solutions.
Step 3: Configure the source and destination
In the data source selection section, select the tables from which you want to read data and the tables to which you want to write data, and specify a filter condition when you configure the source.
The operations that you can perform when you configure a batch synchronization task vary based on the reader or writer type. The following tables describe the common operations that you can perform when you configure a batch synchronization task. For information about the operations supported by a reader or writer and how to perform the operations, see the topic for the related reader or writer. For more information, see Supported data source types, Reader plug-ins, and Writer plug-ins.
Operations related to the source
Operation
Description
Specify a filter condition
If you specify a filter condition after you select the tables from which you want to read data, only the data that meets the filter condition in the tables can be synchronized. You can use a filter condition together with scheduling parameters to implement incremental synchronization. This way, the filter condition can dynamically change with the settings of the scheduling parameters, and incremental data can be synchronized. Configurations for incremental synchronization and implementation of incremental synchronization vary based on the reader type. For more information, see Configure a batch synchronization task to synchronize only incremental data.
NoteWhen you configure scheduling properties for the batch synchronization task, you can assign values to the variables that you specified in the filter condition. You can configure scheduling parameters for the batch synchronization task to enable full or incremental data in the source to be written to the related time-based partitions in the destination tables. For more information about scheduling parameters, see Supported formats of scheduling parameters.
The syntax of the filter condition that is used to implement incremental synchronization is almost the same as the syntax supported by a database. During data synchronization, the batch synchronization task uses a complete SQL statement that is obtained based on the filter condition to extract data from the source.
If you do not specify a filter condition, full data in the source tables is synchronized by default.
Specify a shard key used to shard data in a relational database
A shard key specifies a field based on which source data is sharded. After you specify a shard key, source data is sharded and distributed to multiple shards. This way, the batch synchronization task can run parallel threads to read the data in batches.
NoteWe recommend that you specify the name of the primary key column of a source table as the shard key. This way, data can be evenly distributed to different shards based on the primary key column, instead of being intensively distributed only to specific shards.
A shard key can be used to shard data only of an integer data type. If you use a shard key to shard data of an unsupported data type, the batch synchronization task ignores the shard key that you specified and uses a single thread to read data.
If no shard key is specified, a data synchronization task uses a single thread to read data.
Support of readers for the configuration of a shard key varies based on the reader type. The instructions provided in this topic are for reference only. You can refer to the topic for a reader to check whether the reader supports the configuration of a shard key. For more information, see Supported data source types, Reader plug-ins, and Writer plug-ins.
Operations related to the destination
Operation
Description
Configure SQL statements that you want to execute before and after data synchronization
DataWorks allows you to execute SQL statements before and after data is written to specific types of destinations.
For example, when you configure a batch synchronization task that uses MySQL Writer, you can configure the SQL statement
truncate table tablename
as a statement to be executed before data is written to the destination. This statement is used to delete existing data in a specified table. You can also configure an SQL statement as a statement to be executed after data is written to the destination.Specify the write mode that is used when a conflict occurs
You can specify the write mode in which you want to write data to the destination when a conflict, such as a path conflict or primary key conflict, occurs. The configuration varies based on the attributes of destinations and the support of writers. To configure this item, refer to the topic for the related writer.
Step 4: Configure mappings between source fields and destination fields
After the source and destination are configured, you must configure mappings between source fields and destination fields. After the mappings between source fields and destination fields are configured, the batch synchronization task writes the values of the source fields to the destination fields of the same data type based on the mappings.
The data type of source fields may be different from that of destination fields. In this case, the values of the source fields cannot be written to the destination fields. The values that fail to be written to the destination are considered as dirty data. You can refer to the operations described in the Configure channel control policies step to specify the maximum number of dirty data records that are allowed during data synchronization.
If a source field has no mapped destination field, data in the source field cannot be synchronized to the destination.
You can map source fields to destination fields whose names are the same as those of source fields or map fields in a row of the source to the fields in the same row of the destination. When you configure field mappings, you can also perform the following operations:
Add fields to a source table and assign values to the fields: You can click Add a row in the source field list to add fields to the source table. The fields can be constants, scheduling parameters, and built-in variables that are enclosed in single quotation marks ('), such as '123', '${Scheduling parameter name}', and '#{Built-in variable name}#'.
NoteIf you add scheduling parameters to the source table as fields, you can assign values to the scheduling parameters when you configure scheduling properties for the batch synchronization task. For information about scheduling parameters, see Supported formats of scheduling parameters.
Manually add built-in variables to a source table as fields and map the fields to the fields in the destination table. The added built-in variables are synchronized to the destination table during data synchronization.
The following table describes the built-in variables that are available for different readers.
Built-in variable
Description
Reader
'#{DATASOURCE_NAME_SRC}#'
The name of a source.
MySQL Reader
MySQL Reader (Sharding)
PolarDB Reader
PolarDB Reader (Sharding)
PostgreSQL Reader
'#{DB_NAME_SRC}#'
The name of the database to which a source table belongs.
MySQL Reader
MySQL Reader (Sharding)
PolarDB Reader
PolarDB Reader (Sharding)
PostgreSQL Reader
'#{SCHEMA_NAME_SRC}#'
The name of the schema to which a source table belongs.
PolarDB Reader
PolarDB Reader (Sharding)
PostgreSQL Reader
'#{TABLE_NAME_SRC}#'
The name of a source table.
MySQL Reader
MySQL Reader (Sharding)
PolarDB Reader
PolarDB Reader (Sharding)
PostgreSQL Reader
Edit fields in a source table: You can click the icon in the source field list to perform the following operations:
Use a function that is supported by the source to process fields in the source table. For example, you can use the Max(id) function to implement synchronization of data in the row with the largest ID in the source table.
If only some fields in the source table are displayed when you configure field mappings, edit the fields in the source table.
NoteFunctions are not supported if you configure a batch synchronization task that uses MaxCompute Reader.
Step 5: Configure channel control policies
You can configure channel control policies to define attributes for data synchronization.
Parameter | Description |
Task Expected Maximum Concurrency | The maximum number of parallel threads that the batch synchronization task uses to read data from the source or write data to the destination. Note
|
Synchronization rate | Specifies whether to enable throttling.
Note The bandwidth is a metric provided by Data Integration and does not represent the actual traffic of an elastic network interface (ENI). In most cases, the ENI traffic is one to two times the channel traffic. The actual ENI traffic depends on the serialization of the data storage system. |
Policy for Dirty Data Records | The maximum number of dirty data records allowed. Important If a large amount of dirty data is generated during data synchronization, the overall data synchronization speed is affected.
Note Dirty data indicates data that is meaningless to business, does not match the specified data type, or leads to an exception during data synchronization. If an exception occurs when a single data record is written to the destination, the data record is considered as dirty data. Data records that fail to be written to a destination are considered as dirty data. For example, when a batch synchronization task attempts to write VARCHAR-type data in a source to an INT-type field in a destination, a data conversion error occurs, and the data fails to be written to the destination. In this case, the data is dirty data. When you configure a batch synchronization task, you can control whether dirty data is allowed. You can also specify the maximum number of dirty data records that are allowed during data synchronization. If the number of generated dirty data records exceeds the upper limit that you specified, the batch synchronization task fails and exits. |
Distributed Execution | Specifies whether to enable the distributed execution mode for the batch synchronization task.
If you have a high requirement for data synchronization performance, you can use the distributed execution mode to run your batch synchronization task. If you run your batch synchronization task in distributed execution mode, fragment resources of ECS instances can be utilized. This improves resource utilization. Important
|
In addition to the preceding configurations, the overall data synchronization speed of a batch synchronization task is also affected by factors such as the performance of the source and the network environment for data synchronization. For information about the data synchronization speed and performance tuning of a batch synchronization task, see Speed up or slow down the batch synchronization process.
Step 6: Configure scheduling properties for the batch synchronization task
If you want DataWorks to periodically schedule your batch synchronization task, you must configure scheduling properties for the task. This step describes how to configure scheduling properties for a batch synchronization task. You can go to the configuration tab of the batch synchronization task and click Properties in the right-side navigation pane to configure scheduling properties for the task. For information about how to use scheduling parameters, see Description for using scheduling parameters in data synchronization.
Configure scheduling parameters: If you use variables when you configure the batch synchronization task, you can assign scheduling parameters to the variables as values.
Configure time properties: The time properties define the mode in which the batch synchronization task is scheduled in the production environment. In the Schedule section of the Properties tab of the task, you can configure properties such as the instance generation mode, scheduling type, and scheduling cycle for the task.
Configure the resource property: The resource property defines the exclusive resource group for scheduling that is used to issue the batch synchronization task to the related exclusive resource group for Data Integration. You can select the exclusive resource group for scheduling that you want to use in the Resource Group section of the Properties tab.
NoteDataWorks uses resource groups for scheduling to issue batch synchronization tasks in Data Integration to resource groups for Data Integration and uses the resource groups for Data Integration to run the tasks. You are charged for using the resource groups for scheduling to schedule batch synchronization tasks. For information about the task issuing mechanism, see Mechanism for issuing tasks that are run on old-version resource groups.
Step 7: Commit and deploy the batch synchronization task
If you want to periodically run the batch synchronization task, you must deploy the task to the production environment. For more information about how to deploy a task, see Deploy tasks.
What to do next
After the batch synchronization task is deployed to the production environment, you can go to Operation Center in the production environment to view the task. For information about how to perform O&M operations for a batch synchronization task, such as running and managing the task, monitoring the status of the task, and performing O&M for the resource group that is used to run the task, see O&M for batch synchronization tasks.
